How to write an itemized quote, with a sample

What goes on each line of an itemized quote, a full sample for a bathroom remodel, the terms under the total, and why splitting labor from materials matters for sales tax.

Zirko RedaktionPublished: 6 min read

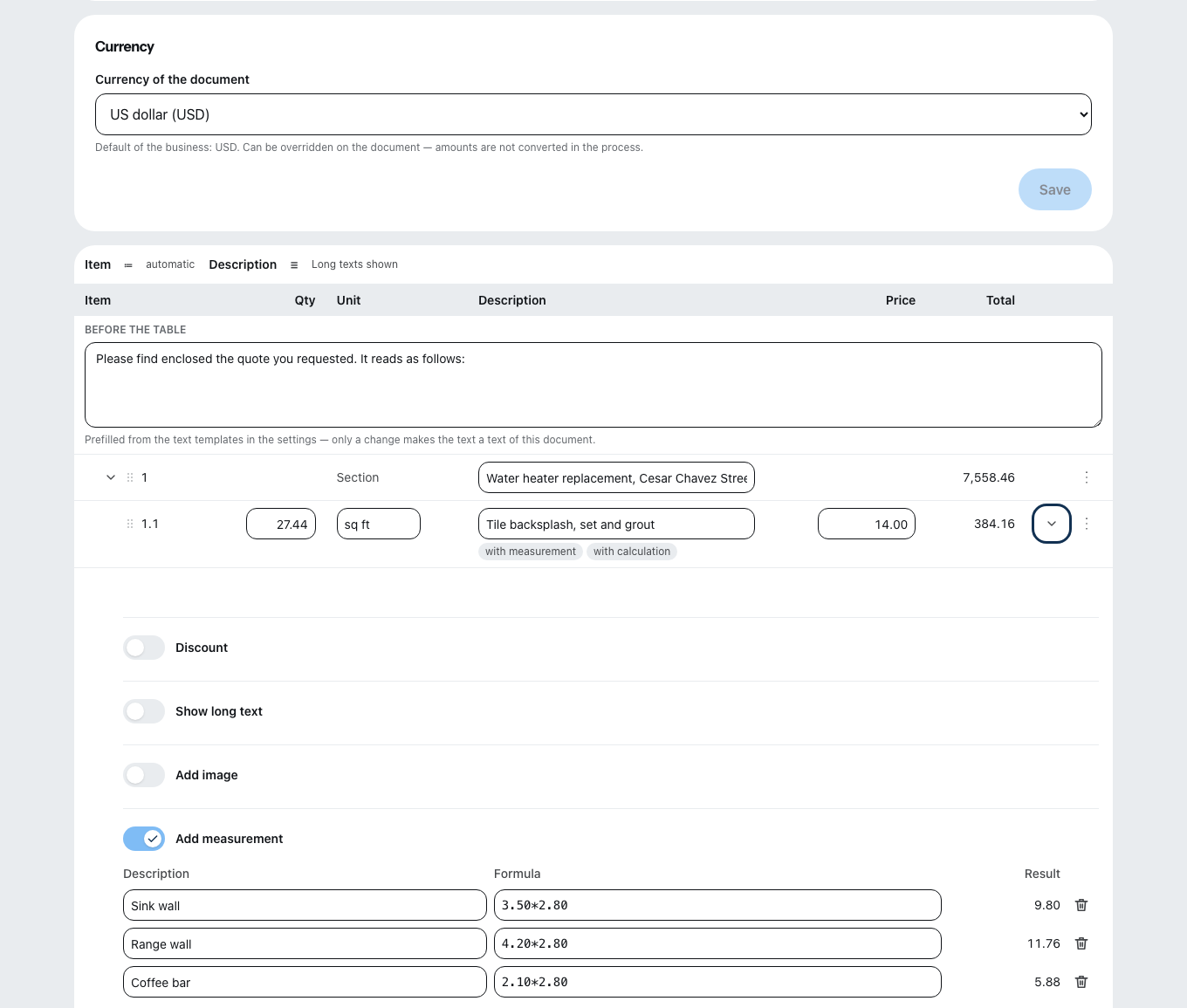

A quote in the document editor in US dollars: a text above the line items saying the quote reads as follows, a section for a water heater replacement, a line for a tile backsplash priced per square foot with the tags with measurement and with calculation, and below it the measurement rows for the sink wall, the range wall and the coffee bar, each with its formula and result.
Contents

An itemized quote breaks the price of a job into lines a customer can check one by one: description, quantity, unit, unit price and line total, with labor and materials kept apart, allowances and exclusions written out, and the total, tax, payment schedule, validity date and acceptance line underneath. A one-number quote gets accepted or rejected as a whole. An itemized one gets discussed — and usually two lines get questioned instead of the whole price.

The pricing behind the lines — takeoff, markup against margin, the loaded labor rate — is in Contractor estimate: from takeoff to a price that holds. This article is about the document the customer holds in their hand.

What one line has to carry

Every line answers five questions, and a line that skips one invites the call you are trying to avoid:

  1. What — a description specific enough that a stranger could check it was done: "Tile backsplash, 4×12 ceramic, set and grout", not "Tile".
  2. How much — the quantity, taken off, not guessed.
  3. In what unit — sq ft, linear ft, each, hour, lump sum. A unit makes a quantity checkable.
  4. At what price per unit.
  5. The line total — quantity × unit price, so the customer's calculator agrees with yours.

Group the lines into sections that follow the job — demolition, rough-in, finishes — and keep labor and materials on separate lines inside each section. That split is what lets you price a change by editing one quantity, and it is what the job gets costed against afterward.

A sample: itemized quote for a bathroom remodel

Quote Q-1042 · valid 30 days from October 4, 2026 · for a homeowner in Austin, Texas.

#DescriptionQtyUnitUnit priceTotal
1Demolition
1.1Remove tub, vanity, tile and drywall to studs; haul off1lump sum$1,450.00$1,450.00
2Plumbing rough-in
2.1Labor: relocate shower valve and drain10hr$95.00$950.00
2.2Materials: valve body, PEX, fittings1lot$386.00$386.00
3Tile
3.1Labor: shower walls, set and grout96sq ft$14.00$1,344.00
3.2Materials: backer board, membrane, thinset, grout96sq ft$4.25$408.00
3.3Allowance: wall tile, customer's choice110sq ft$6.00$660.00
4Fixtures
4.1Labor: set vanity, toilet, trim kit6hr$95.00$570.00
Subtotal$5,768.00

Underneath, before the signature line:

  • Labor $4,314.00 · materials $1,454.00 (lines 2.2, 3.2 and 3.3), shown separately so the tax can be computed on materials.
  • Sales tax on materials only, at the local rate that applies at the job site — this sample is written as a separated contract (see below).
  • Allowance 3.3 covers 110 sq ft of tile at $6.00/sq ft. Tile chosen above that price is billed at the difference on a written change order.
  • Excluded: fixtures supplied by the owner, permits, electrical work, repair of framing or subfloor found rotten after demolition — priced as a change order if found.
  • Payment: deposit on signing, then payments tied to completed stages; no payment ahead of work performed.
  • Valid until November 3, 2026. Material prices after that date are re-quoted.
  • Accepted: name, signature, date.

Check the arithmetic the way your customer will: 1,450 + 950 + 386 + 1,344 + 408 + 660 + 570 = 5,768.00.

Why the split between labor and materials is not just tidiness

In some states the way you itemize decides who pays sales tax on materials. The Texas Comptroller's publication on residential repair and remodeling describes two contract forms:

  • Lump-sum contract — "one price for the entire job". You pay tax on your supplies when you buy them, and "you don't charge your customer tax."
  • Separated contract — you "charge separately for materials and labor", give your supplier a resale certificate for materials you incorporate, and collect sales tax "from your customer on the amount you charge for the materials."

Same bathroom, two cost bases, and the quote is where the choice gets made — usually by accident. Other states treat contractors differently again: Sales tax on construction: one job, three states, three answers.

In California, a home improvement contract over $500 has to carry a description under a prescribed heading: "Description of the Project and Description of the Significant Materials to be Used and Equipment to be Installed" (Business and Professions Code 7159). An itemized quote that names the valve, the tile and the fixtures already holds most of what that section needs once the quote becomes the contract — the deposit and payment rules from the same code are in the estimate article linked above.

Signed at the kitchen table: the three-day rule

If the customer signs your quote at their home, federal law may give them three business days to change their mind. The FTC's Cooling-Off Rule covers a sale of $25 or more made at the buyer's residence (16 CFR 429.0). The seller has to hand over a copy of the contract with a cancellation statement next to the signature line and a completed form headed "NOTICE OF CANCELLATION" or "NOTICE OF RIGHT TO CANCEL", in the language used in the sales presentation (§ 429.1).

Not every home visit falls under it. The exclusions include a bona fide emergency where the buyer called you and gives a dated, signed statement in their own handwriting waiving the right to cancel, and repairs to the buyer's personal property that the buyer asked you to come and do. Several states add their own home-solicitation rules on top. If you sign quotes at the kitchen table, put the notice into your quote template once, rather than deciding job by job.

Terms that belong under the total

The terms are where the itemized lines get their meaning. The ones contractors regret leaving out:

  1. Validity — a date, not "subject to change".
  2. What an allowance means — quantity, unit rate, and what happens above it.
  3. Exclusions — whatever is not written out is assumed to be included.
  4. Hidden conditions — rot, asbestos, rock: how they are priced when found.
  5. Changes — priced and signed before the work, not after.
  6. Payment schedule — tied to work performed, with the deposit stated in dollars.
  7. Permits and inspections — who pulls them, who pays.

Position as at October 4, 2026, checked against 16 CFR Part 429 on the eCFR, California Business and Professions Code 7159 and Texas Comptroller publication 94-116. What may change: the FTC rule's dollar thresholds are set by rulemaking and can be raised; state home-solicitation and sales tax rules change by statute — check the state where the job is, not the state where your office is.

What Zirko does here: a quote is built from sections and line items with quantity, unit, unit price and a line total, labor and materials on separate lines with a markup per cost type, and a measurement chain under any line that stays editable; opening and closing texts hold your terms, and the same lines travel into the order confirmation and the invoice without retyping. A customer can sign the PDF remotely, which records who signed which version and when. What Zirko does not do: it proposes no sales tax rate — you enter the rates that apply to you — it does not decide whether a sale falls under the Cooling-Off Rule, and it keeps no "accepted" status on a quote. More on job documents and the costing behind the lines on job costing.

Frequently asked questions

What is the difference between a quote and an estimate?

In everyday use, a quote is a price you intend to hold if the customer accepts it in time, and an estimate is an approximation that may move. Neither word has one legal definition across the states, so the document itself has to say which it is: write the validity date, what is fixed and what is an allowance, and how changes will be priced.

What terms and conditions belong on a contractor quote?

At minimum: how long the price is valid, the payment schedule tied to work performed, that changes are priced and signed in writing before the work starts, what is excluded, what happens with hidden conditions, who pulls permits, and the warranty. On a sale made at the customer's home, the cancellation notice required by the FTC's Cooling-Off Rule belongs there too.

Does a customer have three days to cancel a signed quote?

Often, if they signed it at their home. Under the FTC's Cooling-Off Rule (16 CFR Part 429), a sale of $25 or more made at the buyer's residence can be canceled until midnight of the third business day, and the seller must hand over a completed notice of cancellation. Exclusions include a bona fide emergency the buyer initiated and waived in a handwritten, signed statement.

Should materials be itemized separately from labor?

Yes, and in some states it changes the tax. In Texas, on residential repair and remodeling, a lump-sum contract means you pay sales tax on materials when you buy them and charge the customer none; a separated contract, which charges separately for materials and labor, means you collect sales tax from the customer on the materials charge. The split on the quote is where that choice is made.

Try the preview

Zirko launches at the end of 2026. Until then you can try an early test version — sign up, confirm your address and you're in straight away. One more email at launch, nothing more.

Available from late 2026

Once you confirm, you get early access straight away, plus the link by email, and one last email at the official launch. You confirm with a click and can unsubscribe at any time. We delete your address 30 days after the launch email, and at the latest one year after you confirm. Details in the privacy policy.

Continue reading

Sources

Back to the overview
